Develocity IntelliJ Plugin User Manual


The Develocity IntelliJ plugin seamlessly integrates Develocity and Build Scan capabilities directly into your IDE.

  • It displays a live build timeline of task/goal execution and resource usage within your IntelliJ IDE, for all your Gradle and Maven builds.

  • It can automatically configure your Gradle build to publish Build Scans to gradle.com or your Develocity server.

  • It decorates your Java/Kotlin/Groovy test source files with historical test results.

Features

Live Build Timeline

Available for: All Users

The plugin displays a live timeline of task/goal execution and resource usage within the IntelliJ Run tool window. This helps identify bottlenecks and visualize parallelism.

Run a Gradle or Maven build (e.g., via Run Configuration or Gradle Sync). The timeline appears in the build output window.

Live build timeline
  • Gradle

  • Maven

Live Gradle build timeline
Live build timeline
Live Maven build timeline
Live build timeline
Hover over blocks to see task/goal duration and type.
CPU and Memory resource usage is visible while the build runs.

Build Scan Publication

Available for: Users publishing to gradle.com or users with a Develocity server

The plugin can automatically configure your Gradle build to publish Build Scans to gradle.com or your Develocity server.

When a Build Scan is published, a notification with a link to the Build Scan appears in the IDE, and you can also access the Build Scan from the timeline toolbar and task/goal details.

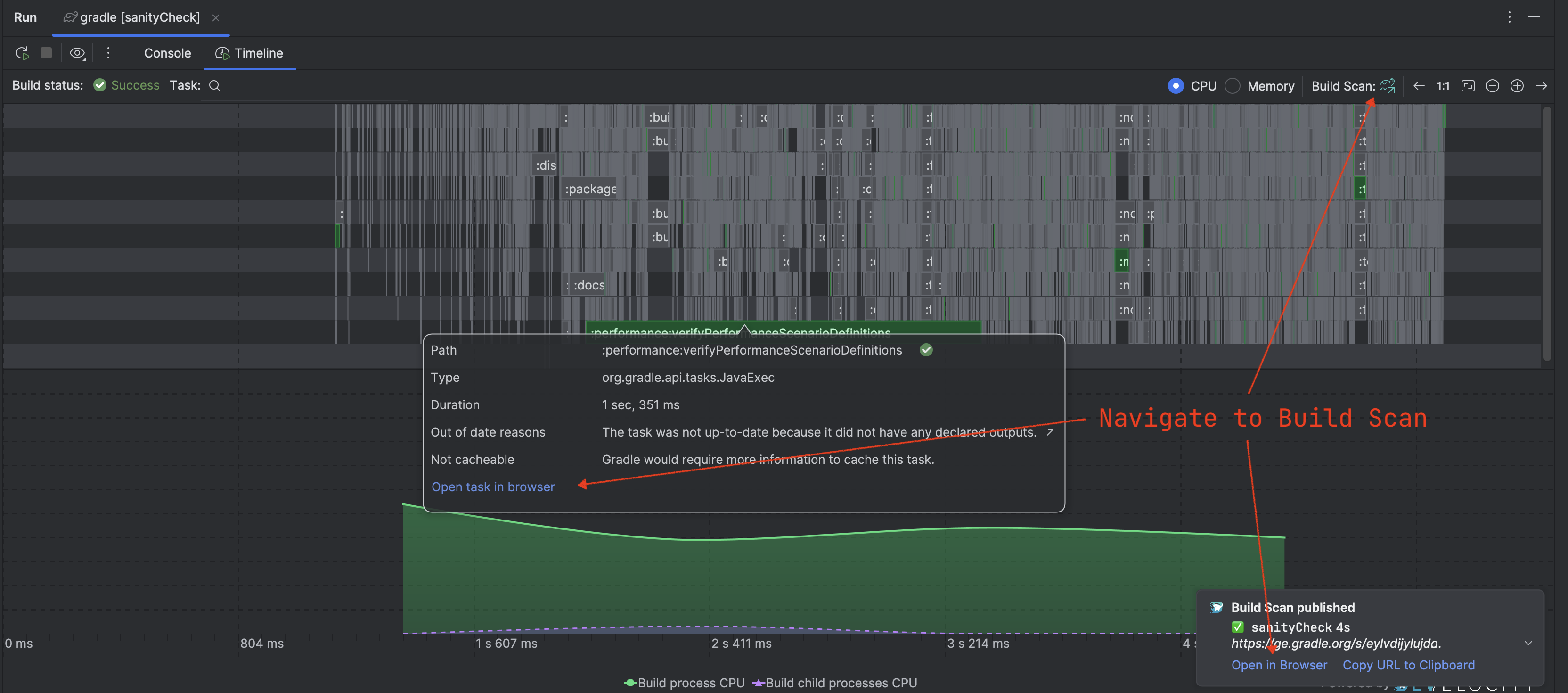

Accessing the published Build Scan
Accessing the published Build Scan
To learn more about Build Scans, see https://scans.gradle.com.

Test History

Available for: Users connected to a Develocity Server with the Test Analytics feature enabled

When connected to a Develocity server, the plugin decorates your Java/Kotlin/Groovy test source files with historical results. By default, all Build Scans published to your Develocity server (i.e. from you or other local users, and from CI agents) contribute to this analysis. You can use query patterns to scope the data to specific builds.

Test class and test methods are decorated with inlays showing recent pass/fail/flakiness history.

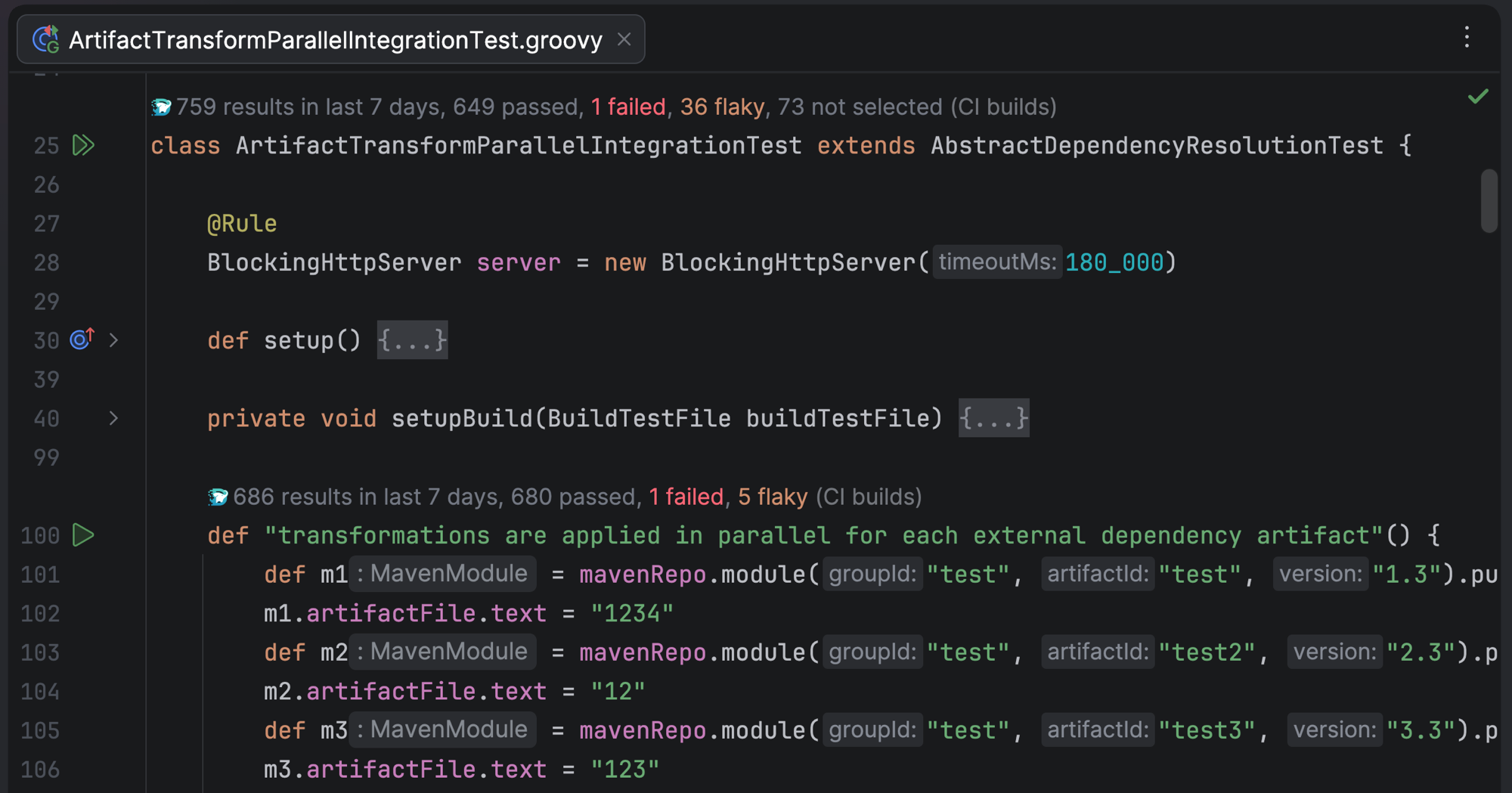

Test history
Test history
Test history requires permission to access the Develocity Test API. The provided access key must have the Access build data via the API permission.
Test history can be configured via the settings to work with data from the past day, or the past 7 days.

Query Patterns

By default, test history includes data from all builds published to your Develocity server. Query patterns let you define named filters to scope which builds contribute to the test history analysis.

For example, you might create a pattern that only includes CI builds, or one that focuses on builds from a specific branch.

Query patterns are managed in the plugin settings. Each pattern has a name and a filter expression using the Develocity search syntax. A built-in "All builds" pattern is always available and includes all builds without filtering.

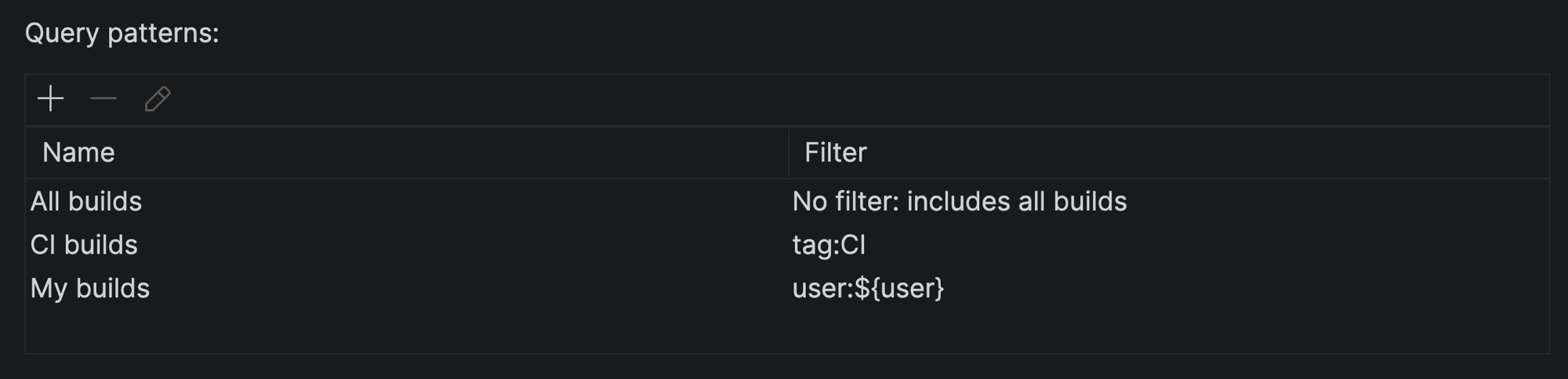

Query patterns in the plugin settings
Query patterns in the plugin settings

By default, all terms in a filter must match. Terms can be combined using boolean and and or operators, grouped using parentheses, and negated using - or not.

Example query patterns
Name Filter

CI builds only

tag:CI

My builds on CI

tag:CI user:${user}

My branch

value:"Git branch=${currentBranch}"

Local or custom tag

tag:local or tag:foo

CI on a specific project

project:my-project tag:CI

The active query pattern is shown in the IDE status bar. Click the status bar widget to quickly switch between patterns.

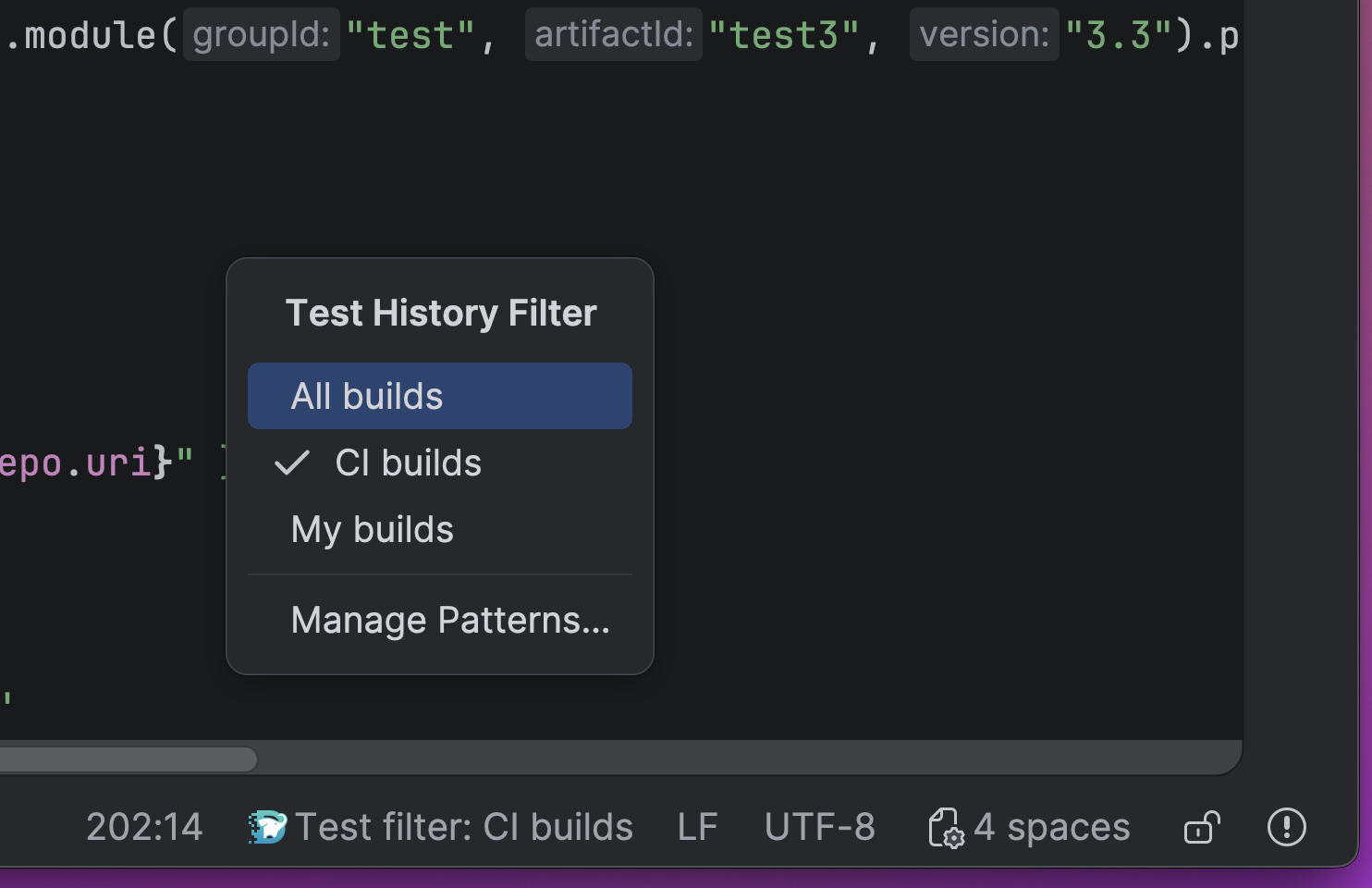

Status bar widget for switching query patterns
Status bar widget for switching query patterns
Placeholders

Filter expressions support the following placeholders, which are resolved dynamically:

Placeholder Description

${currentBranch}

Resolves to the name of the current Git branch of the open project. Only Git is currently supported; if the branch can’t be determined (for example, the project isn’t a Git repository), any filter clause containing this placeholder is silently removed.

${user}

Resolves to the current operating system user name.

Installation

  • Open IntelliJ IDEA.

  • Go to File  Settings (or IntelliJ IDEA  Settings on macOS).

  • Navigate to Plugins.

  • Select the Marketplace tab.

  • Search for "Develocity".

  • Click Install next to the "Develocity" plugin and restart your IDE when prompted.

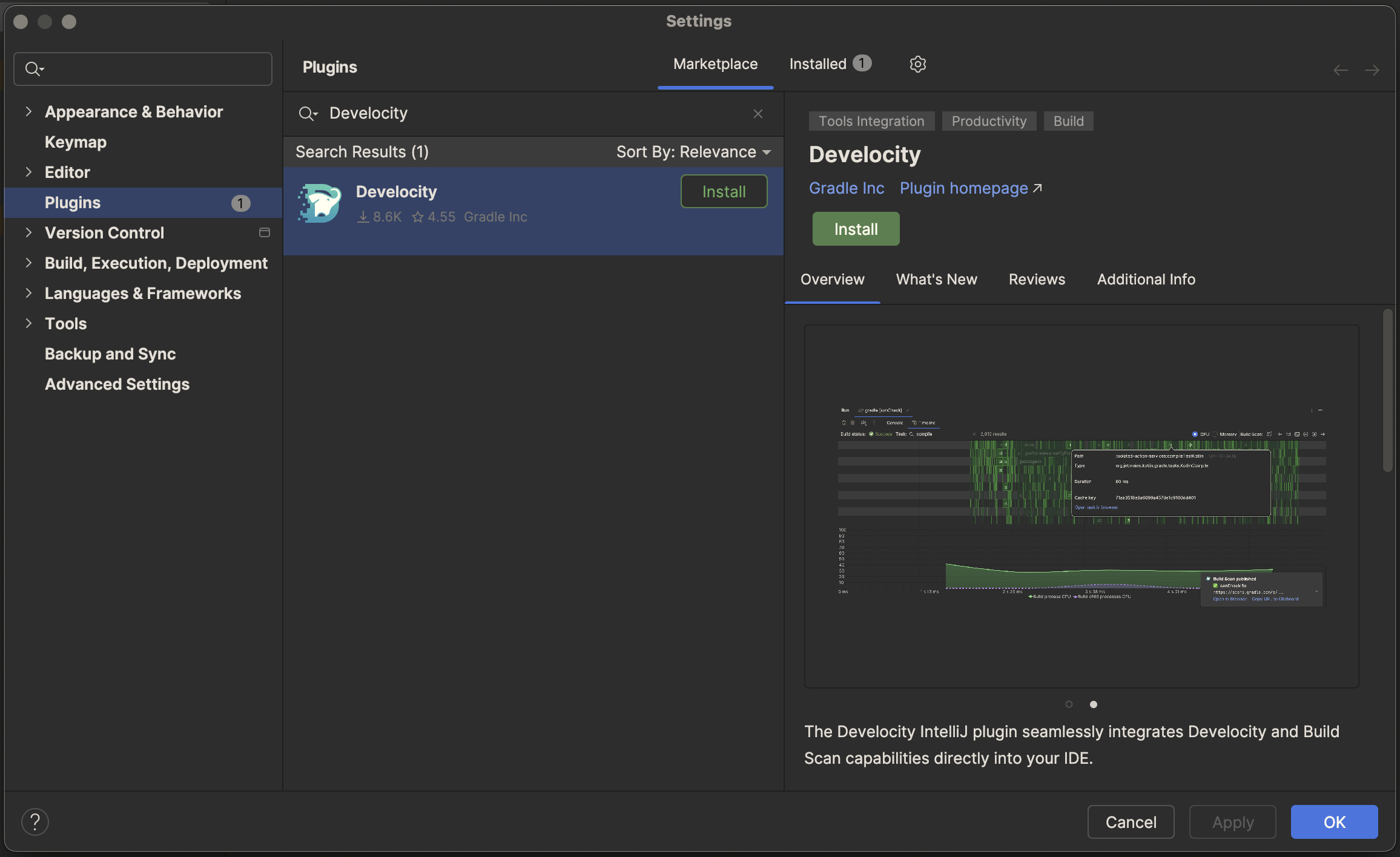

Plugin Installation
Plugin Installation

Getting Started

Choose the setup path that best matches your environment.

Path A: Standalone (Local)

For users who want local build insights without connecting to a Develocity server.

You can benefit from the live build timeline feature:

  1. Open the settings via File  Settings  Tools  Develocity (or IntelliJ IDEA  Settings  Tools  Develocity on macOS).

  2. Set Develocity Connection to None.

  3. Ensure the Live build timeline feature is selected.

  4. To see the live build timeline, your build needs to be configured:

    • Gradle: Select the Configure the build and Apply Develocity Gradle plugin checkboxes to configure it automatically.

    • Maven: You must manually add the Develocity Maven extension. See the Develocity Maven Extension User Manual.

⇒ Your next build will now show a live timeline while executing.

Live build timeline
  • Gradle

  • Maven

Live build timeline
Live build timeline
Live build timeline
Live build timeline

Path B: Connected (gradle.com)

For users who want deep build insights using the free Build Scan service.

In addition to the live build timeline mentioned above, you can decide to publish a free Build Scan to gradle.com for deeper insights into your build.

To learn more about Build Scans, see https://scans.gradle.com.

To publish Build Scans to gradle.com:

  1. Open the settings via File  Settings  Tools  Develocity (or IntelliJ IDEA  Settings  Tools  Develocity on macOS).

  2. Set Develocity Connection to Develocity at gradle.com.

  3. Configure your build to accept the Gradle Terms of Use:

    • Gradle: Select the Configure the build and I agree to the Gradle Terms of Use checkboxes.

    • Maven: You must manually add the Develocity Maven extension and accept the Terms of Use. See the Develocity Maven Extension User Manual.

⇒ Your next build will now publish a Build Scan to gradle.com when it completes, and a notification with a link to the Build Scan will appear in the IDE.

Accessing the published Build Scan
Accessing the published Build Scan

Path C: Connecting with a Develocity Server

For users with access to a Develocity server.

If your organization uses Develocity, connecting the plugin unlocks historical test results, in addition to the live build timeline and automatic Build Scan publishing features mentioned above.

  1. Open the settings via File  Settings  Tools  Develocity (or IntelliJ IDEA  Settings…​ on macOS).

  2. Set Develocity Connection to Develocity server.

  3. Enter your Develocity Server URL.

  4. Authenticate with your credentials, if needed:

    • Click the Log in…​ button.

    • Authentication can be auto-discovered based on existing configuration files on your machine, or a known access key can be provided or generated via your browser.

    • Authentication is required to access Test History features.

  5. Ensure the Test history in source files feature is selected.

⇒ Test history will be available in your Java/Kotlin/Groovy test source files.

Test history
Test history

Configuration Reference

Configuration is managed via File  Settings  Tools  Develocity (or IntelliJ IDEA  Settings  Tools  Develocity on macOS).

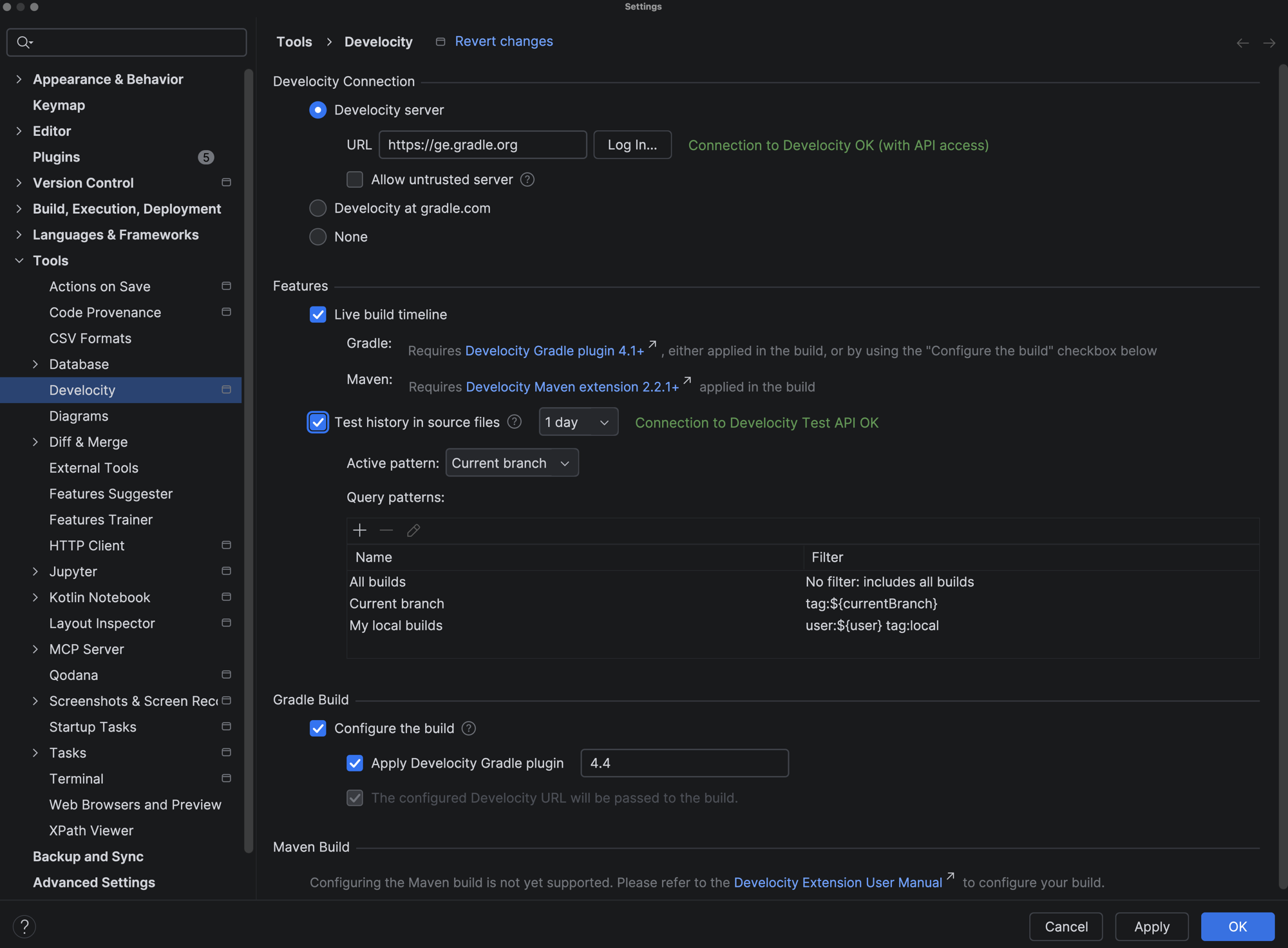

Develocity Configuration
Develocity Configuration
Develocity Connection Description

Develocity Server

Select this option when connecting to a Develocity server (e.g. your organization’s Develocity server).

  • URL: Specify the URL of your Develocity server (e.g., https://develocity.example.com).

  • Log in…​: Specify the access key to be used to authenticate with the Develocity server.

    • Required for the Test History feature.

  • Allow untrusted server: Enables connecting to Develocity servers with self-signed or untrusted SSL certificates.

Develocity at gradle.com

Select this option when connecting to the free Develocity service at gradle.com.

None

Select this option when not connecting to any Develocity server (local-only usage).

Features Description

Live build timeline

Enables the live build timeline feature for Gradle and Maven builds executed within IntelliJ.

Test history in source files

Enables test history in Java/Kotlin/Groovy test source files.

  • Requires connection to a Develocity server with the Test Analytics feature enabled.

  • A time range for the test history data can be specified (past day or past 7 days).

  • Query patterns can be defined to filter which builds contribute to the test history analysis. Patterns use the Develocity search syntax and support dynamic placeholders like ${currentBranch} and ${user}.

Gradle build Description

Configure the build

Automatically configures your Gradle build without modifying its Gradle files.

  • Apply Develocity Gradle plugin: Specify the Develocity Gradle plugin to be used.

  • When configured, the Develocity server URL is also passed to the build and will take precedence over any in-build configuration.

Maven build Description

Configure the build

Automatically configuring your Maven build is currently not supported.
You will need to manually add the Develocity Maven extension to your build.
See the Develocity Maven Extension User Manual for instructions.

Troubleshooting

Live Build Timeline Shows No Data

Symptom

The timeline view displays a message like "Something went wrong and no data was received from the build."

Cause

The Develocity IntelliJ plugin isn’t receiving data from the Develocity Gradle plugin / Develocity Maven extension. This typically happens if the Gradle plugin / Maven extension version applied to your build is older than the minimum required version.

Solution

Ensure your build applies Develocity Gradle plugin 4.1 or newer, or Develocity Maven extension 2.2.1 or newer.

Some of My Maven Builds Aren’t Shown in the Live Build Timeline

Symptom

The timeline view isn’t displayed for some Maven builds.

Cause

The build isn’t delegating to Maven, but uses the internal IDE build mechanism. For instance Maven sync/reload aren’t delegating to Maven, or the IDE can be configured to run tests without delegating to Maven.

Solution

Configure your IDE to delegate the build/test actions to Maven, or don’t expect the timeline view to be shown for such builds.

Live Build Timeline Is Affecting the Performance of My Machine

Symptom

CPU usage spikes when the timeline view is visible.

Cause

The timeline view might repaint too frequently for the capabilities of your machine.

Solution

Go to Help  Find Action, type Registry and press Enter to open the IDE registry. Then look for the key com.gradle.develocity.ide.timeline.refresh.millis. You can specify any value between 10ms and 5000ms. Try a bigger value to reduce the performance impact of the timeline view.

Connection to Develocity Server Fails

Symptom

The settings page displays a message like "Connection to Develocity failed".

Cause

The Develocity server URL is incorrect, or there is a network issue preventing the connection.

Solution

Verify the Develocity server URL is correct, and that your machine can reach the server.

Connection to Develocity Server Indicates "no API access"

Symptom

The settings page displays a message like "Connection to Develocity OK (without API access)".

Cause

No access key was automatically discovered or provided.

Solution

Click the Log in…​ button and provide a valid access key with the Access build data via the API permission.

Connection to Develocity Test API Fails

Symptom

The settings page displays a message like "Connection to Develocity Test API failed".

Cause

The provided access key doesn’t have the Access build data via the API permission, or the Develocity server doesn’t have the Test Analytics feature enabled.

Solution

Provide an access key with the Access build data via the API permission, or contact your Develocity server administrator to enable the Test Analytics feature.
